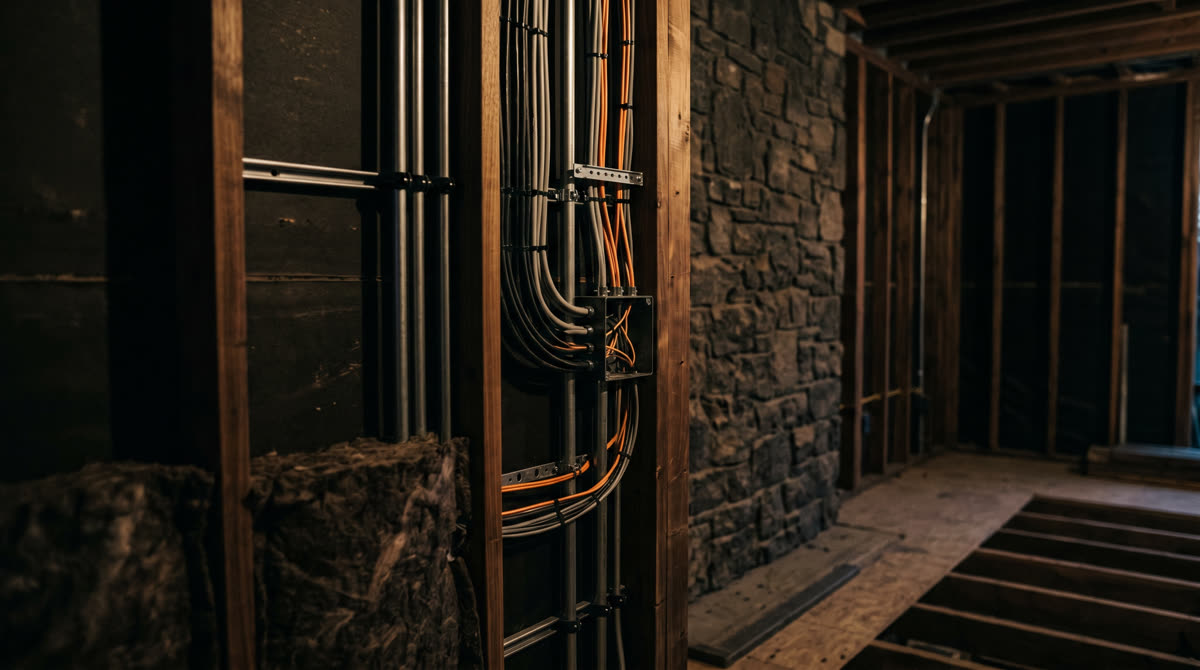

Quick Answer: Get the integrator at the design table before the foundation is poured. Run conduit, not just wire. to every TV, between mechanicals, basement to attic, with NEC-compliant fill room to grow. Always pull at least two cables to every endpoint, four behind every TV. Use fiber, never copper, between separate buildings. Pre-wire ceilings for Atmos before drywall, every window for shades, and every wet area for leak detection. Plan for generator, EV, solar, and whole-home surge at framing. Build self-healing into the system from day one. The house does not need to work all the time. it needs to work every time the customer touches it.
This page is the conversation I wish every homeowner could have with their integrator before the foundation is poured. After 20+ years on luxury new builds. from 1,500 square foot condos to 30,000 square foot estates across New Jersey, Connecticut, New York, and now an ultra-high-end engagement in Tennessee. I have learned that the difference between a home you love and a home you tolerate gets decided at framing, not at finish. The trades, the GC, the architect, and the other integrators are doing their jobs. Almost no one is doing yours. That is what an Owner’s Rep is for. The questions below cover the things I would tell my own family before they broke ground. If something here contradicts what your builder or another integrator told you, ask them to show you the receipts. Then ask me.. Michael Restrepo
<.-- FAQ SECTION -->Frequently Asked Questions
Why should an integrator be at the design table before the foundation is poured?
Because someone has to advocate for the homeowner, and after 20+ years on luxury new builds I have learned that role usually does not exist unless you create it. That is why we play Owner’s Rep. We sit at the design table and we mark up plans. We bring the years of experience of having seen the issues from not doing it right upfront. and the cost. Not just the dollar cost. The time the home is not done, the dust and demo when you have to open walls to fix it, and the worst part of all: watching a homeowner not get what they originally wanted because by week 47 of construction they are tired and they cave on the last 10 percent. The Owner’s Rep’s job is to make sure what was decided in the design meeting is what actually lands in the home. We are doing this right now on a current ultra-high-end project in Tennessee. we are doing the engineering and design AND the quality control, making sure no other trade, no builder, and no other integrator over-talks the customer. That is the seat the homeowner needs filled, and almost no one fills it for them.
What does “Owner’s Rep’” actually mean on a luxury new build?
It means we are on your side of the table. Period. We sit in the design meetings and ask the questions you do not know to ask. We mark up plans before the trades break ground. We push back on the GC, the architect, and the other trades when they try to value-engineer something the homeowner actually wants. We push back on other integrators who try to oversell or upsell at the customer’s expense. We make sure the wiring spec, the conduit, the rack location, the rough-ins, and the finish-stage details actually match what the customer asked for. And we coordinate the trades. pool, irrigation, HVAC, security, electrical, low voltage, AV. so the home builds as one project, not eight projects fighting for the same wall. Owner’s Rep is not a buzzword. It is the difference between a home that does what you wanted and a home that does what the trades had time for.
What does it actually cost to fix a low-voltage mistake after drywall vs during framing?
Roughly 5x to 20x in dollars, but the dollars are not the worst part. During framing, a missed cable run takes a low-voltage tech 30 minutes and a bag of staples. After drywall, that same run costs you a drywall demo, a low-voltage pull, a drywall patch, prime, paint, dust mitigation, scheduling all four trades to come back, and weeks of delay because each trade has to wait for the one before. You also pay in homeowner exhaustion. By the time you are post-drywall, the homeowner is so tired of construction that they will accept compromises they would never have accepted at framing. That is the hidden cost. The fix is not expensive at framing. It is invisible at framing. Doing it right at framing is the cheapest decision on the whole job, and it is the one most often skipped.
What conduit do I actually need run during framing in a luxury new build?
Conduit is the spine of a future-proof home, and people skip it because it is invisible at the time. The non-negotiables: run conduit to every TV location, not just wire. so you can pull new cable later when the technology changes (and it always changes). Run conduit between mechanical areas so low voltage has a clean path without opening walls. Run conduit from the basement mechanical room to the attic. that is the spine of the house. Without it, every future upgrade becomes demolition. Size every conduit per NEC fill rules with real headroom. You are not supposed to fill the tube. Code requires fill percentages, and beyond code, leaving room to grow is what separates a home you can upgrade from a home you cannot. And run separate conduits for low voltage and high voltage. never share. Cost during framing: low. Cost after drywall: brutal.
Why do low voltage and high voltage need separate conduits?
Two reasons, and both matter. First, code. NEC and most local codes require physical separation between line-voltage and low-voltage runs. An inspector who sees Cat6 zip-tied next to Romex inside a shared conduit fails the inspection, and you tear it out. Second, signal integrity. Running data, audio, video, or control cable next to line voltage induces electrical noise that degrades performance. sometimes immediately, sometimes years later when a piece of gear becomes more sensitive. Your network throughput drops. Your audio gets a 60Hz hum. Your control system gets ghost commands. The fix after the fact is rip-and-replace. The fix at framing is a second conduit and 20 minutes of planning. Always two conduits. Always.
Why do you say to never run just one of anything?
Because single runs are a trap. Cable damage during construction happens. A bad terminator happens. A manufacturing defect happens. The technology changes and the cable spec changes. If you have one cable to that endpoint and it fails or becomes obsolete, you are tearing into walls. Always pull at least two of every type to every endpoint. It costs almost nothing during framing. you are already running cable, the tech is already in the wall, the wall is already open. It is the cheapest insurance on the entire project. We had a project recently where I would have lost a relationship without that rule: the pool vendor on an ultra-high-end multimillion-dollar home updated the pool control. God bless. we had pulled additional Cat cable at the unit during the original install. What was originally a simple communication cable got upgraded to a network wire. Because the wiring was already there, no additional cable had to be run to bring the unit online. The end user got phone control of the pool right from the unit, with zero additional integration. Communication speed improved. Integration to the rest of the system improved. None of that happens if the original installer pulled only what was specified instead of what was smart. Always pull at least two.
How many cables should be behind every TV in a new build?
Four minimum. A modern TV location is not a TV location anymore. it is a content endpoint that has to grow with the household for the next 10 to 15 years. Behind every TV I plan for: HDMI back to the rack, two Cat6 (one for control and network, one as spare), and an additional pull string or empty conduit run for whatever comes next. A single HDMI behind a TV is a 2010 spec and it ages worse than the TV itself. With four cables and a pull string, you can swap the TV, swap the source, add an Apple TV, add a streaming box, add an OLED later, add a future display protocol, and you never open a wall. The cost difference between one cable and four cables at framing is rounding error. The cost difference after drywall is a renovation.
What kind of cable should run between separate buildings on a property. pool house, guest house, garage?
Fiber. Never copper. Inter-building copper is a huge problem and I will not run it in any project where structures are separated. Lightning strikes, ground potential differences between buildings, and induced voltage from nearby strikes all ride on copper. One bad event on the pool house and the surge travels back into the main rack and takes out everything in line with it. Fiber is glass. Surges and electrical problems cannot ride across it. Fiber decouples the buildings. One strike on the pool house, the main rack is fine. This is non-negotiable for me on any project with a guest house, pool house, gym, barn, or detached garage. Fiber between buildings, copper inside each building. That is the rule.
What should be hardwired with network drops vs left to mesh Wi-Fi?
Hardwire everything you reasonably can. Mesh is a Band-Aid, not a backbone. Every TV, every camera, every access point, every smart panel, every primary work-from-home location, every game room and theater, and every room a homeowner is likely to use a tablet from. all wired. Wireless is for phones, tablets in motion, and visitors. The reason: a wired drop costs almost nothing during framing and gives you 20 years of full-speed, low-latency, interference-free connectivity. A mesh node is $200, an annoyance, and a future support call. We design Ubiquiti UISP / Pro networks where the wireless layer has actual backhaul and the wired layer carries the load. As an Elite Pro Crestron Dealer and Ubiquiti UISP / Pro Partner, our default is hardwire-first, mesh as a top-up. not the other way around.
What does a proper rack location look like in a luxury home?
It is not a closet jammed under a stair. A real rack location is a dedicated room or alcove with active cooling (a return air vent or a small mini-split if the room is enclosed), a dedicated electrical circuit on its own breaker (ideally two for redundancy), conduit landing into the room from the rest of the house, and physical room to grow. I plan for at least 25 percent more rack space than the day-one design needs, because every project we do adds gear in years 2-5. Accessibility matters too. a tech needs to be able to work in front of and behind the rack without acrobatics. The cost of doing this right at framing is a few square feet of floor plan. The cost of getting it wrong is a hot rack that fails in summer and a service call every quarter to replace whatever cooked itself.
Where should low-voltage panels and termination points live?
Centralized, accessible, and labeled. I put a primary low-voltage termination panel near the main rack and, on larger homes, sub-panels in each major zone (one per floor, or one per wing). Every cable in the house terminates at a panel a tech can actually reach. Not behind drywall. Not above a hard-lid ceiling. Not under a built-in. Behind a hinged or removable access panel, with every run labeled at both ends. This is the difference between a 30-minute service call and a six-hour scavenger hunt. I have seen new builds where the integrator hid all the terminations because they looked ugly. and three years later when something needed to change, the homeowner was opening drywall to find a connector. Plan the panel locations with the architect at design, not with the drywaller at finish.
What outdoor conduit stubs do I need before landscaping closes the trench?
Once the trench gets backfilled, you are not getting it back. Stub conduit out of the foundation to: every patio and outdoor entertainment area (audio, lighting, future TV or projector), the pool equipment area (control, audio, future heater integration, leak detection), the garage (cameras, access control, EV charger control), the front gate or driveway entry (intercom, camera, gate operator, future LPR camera), the front door and any side doors (cameras, doorbell, intercom), perimeter camera locations, the future generator pad, and at least two spare stubs for things you have not thought of yet. Cap them, mark them on the as-built drawing, and walk away. Five years later when the homeowner wants to add a pool-house projector or perimeter cameras, you pull cable through the conduit you stubbed at framing and you do not touch the landscaping.
What in-ceiling pre-wire is critical before drywall in a new build?
Surround sound and Atmos pre-wire is the one homeowners regret skipping more than any other item. Once the ceiling is closed, adding height-channel speakers means cutting holes in finished drywall, dropping speaker wire blind, and patching ceilings. and on coffered, beamed, or hard-lid ceilings it is sometimes flat-out impossible. Any room that might ever host a serious media moment. great room, family room, theater, primary bedroom, study. gets ceiling pre-wire for at least 5.1.4 (five surround, one sub, four height) before drywall, even if the homeowner says they will not install Atmos right now. Cost during framing: a few hundred dollars in cable. Cost later: a full ceiling demo. Same logic for in-ceiling speakers in kitchens, primary bath, screened porch, gym. pre-wire even if the speakers go in later.
Should I pre-wire for motorized shades even if I am not buying them right now?
Yes. Every window. The cost of running low-voltage shade wire to the head of every window during framing is small. The cost of opening every window casing later to add it is enormous, and the patch never comes back perfect. Even if the homeowner is undecided on shades, even if they are leaning toward manual treatments, I run the wire and cap it. If they decide later, they spend on shades only. not on demo. If they never install shades, the wire sits behind a drywall patch and costs them nothing. There is no scenario where pre-wiring for shades costs you more than not pre-wiring. This is the single most asymmetric pre-wire decision in the entire project.
Should I run conduit to art walls and millwork niches?
Yes. to every art wall, every millwork niche, every fireplace surround, every gallery hallway, and every place a homeowner might put a future TV, future display, future feature lighting, or future motorized art lift. Future TVs land in places nobody planned for. Feature lighting gets added years later when the homeowner refines the design. Millwork niches become display cases that need integrated lighting and sometimes a small display. Conduit at framing protects all of those futures. The conduit is empty drywall-side, so it is invisible. The conduit is a future highway homeowner-side. Same rule applies to fireplace surrounds where a TV mount may go later.
What pre-wire belongs in for security cameras, access control, and intercoms?
Every entry door, every garage door, every gate, every perimeter corner of the property, every detached structure, every driveway approach, and every pool / pool equipment / patio entertainment area. Even if cameras are not in the day-one budget, pre-wire to every location with Cat6 plus a spare and a power conductor where appropriate. Access control runs (door strike, REX, request-to-exit, card reader) need their own dedicated low-voltage runs to every door that may ever become controlled. front, side, garage interior to house, mudroom, utility entry. Intercoms at the front gate and front door need their own cable spec with audio plus video plus PoE. Get these in at framing and you get a future security upgrade for the cost of pulling existing wire. Skip it and you pay for trenching, conduit, drywall, and concrete work later.
What lighting infrastructure do I need run before electrical rough-in?
If you are doing real lighting design. Lutron HomeWorks QSX, Lutron RadioRA 3, Ketra, Colorbeam, or any architectural-grade system. the keypad locations and scene logic need to be designed before electrical rough-in, not during. Keypad locations are walls electricians need to know about so they put backboxes in the right spots and at the right heights. Low-voltage runs for the lighting control system need their own pathway. Drivers and control stations need rack space and ventilation planned. Skip this design step and you end up with keypads in the wrong spots, backboxes drilled into the wrong walls, and either a re-rough or a permanent compromise on the lighting design. We design, deploy, install, configure, and support Ketra and Colorbeam projects often, and the projects that go well are the ones where the lighting design was locked in before the electricians showed up. Always before rough-in, never during.
Should I plan for a whole-home generator at framing, even if I am not installing one yet?
Yes. pad, conduit, transfer switch location, and load planning at framing. Generators almost always get added later, especially after a multi-day power outage. If the pad location, gas line stub, electrical conduit run from the future generator to the transfer switch, and the load-shedding plan are all roughed in at framing, adding the generator later is a one-day install. If none of that infrastructure is roughed in, you are trenching across a finished landscape, cutting concrete, opening basement walls, and rerouting an electrical panel. Same logic applies: the cost at framing is near zero, the cost later is brutal. Add a stub for a future battery backup as well. we are deploying more home batteries every year.
What about EV chargers? Where should they go in a new build?
Plan for two EV chargers minimum at framing in any new luxury build, and run conduit and a dedicated subpanel feed even if only one charger goes in day one. Households add a second EV faster than they expect. Locate one in the garage near the primary parking spot and one near a secondary parking location (second garage bay, motor court, guest parking area). Pull the conduit and run the panel feed during framing while the wall is open and the trench is open. Adding an EV charger later through a wall and a finished garage slab is annoying. Adding it later through finished landscape and concrete is expensive. The infrastructure cost at framing is one extra subpanel feed and a length of conduit.
Do you recommend solar pre-wire on a new build even if solar is not in the day-one plan?
Yes. pre-wire to the roof and stub conduit from the future inverter location to the main electrical panel and to the future battery location at framing. Solar adoption keeps growing, utility rates keep climbing, and battery storage keeps getting more capable. Even if the homeowner is not installing solar today, the infrastructure cost at framing is minimal: a roof penetration plan, conduit from roof to inverter location, conduit from inverter to main panel, and a planned location for a future battery. Done at framing, future solar is a clean roof job. Done later, it is a roof job plus exterior conduit running down the side of the house plus drywall demo for the battery. We coordinate solar pre-wire with the electrician and the architect during design so it lands clean and code-compliant.
What about whole-home surge protection and water leak detection at framing?
Whole-home surge protection at the main panel is non-negotiable on any luxury new build. the cost of one decent whole-panel surge device versus the replacement cost of even one rack of AV gear is a joke. Specify it at electrical rough-in and the electrician installs it before energizing. Water leak detection is a different conversation but the framing-stage decision is the same: pull low-voltage cable to every wet area. under every sink, behind every dishwasher and washing machine, near every water heater, around every pool equipment pad, every bathroom floor, and the main water shut-off location. for sensors and an automatic shut-off valve. A leak that wakes you up at 3am because the system shut the water off and texted you is a Tuesday inconvenience. The same leak with no detection is a $200,000 floor and ceiling rebuild. Both decisions are framing-stage, both are cheap when the wall is open, and both are catastrophically expensive when the wall is closed.
Why do I need IP-controlled power for AV gear?
Because the difference between a five-minute fix and a Saturday-morning truck roll is whether your gear can be rebooted remotely. With this much technology in modern homes, remote-rebootable power is not a luxury. it is operational hygiene. Products like SnapAV WattBox, BlueBolt, or Pakedge IP power on every rack and every distributed-AV location mean a tech (or, with the right setup, the homeowner) can power-cycle a hung router, a stuck streamer, a sleeping switch, or a frozen processor from anywhere. We pair IP power with monitoring (Domotz) and the result is a system that fixes most of its small problems before the homeowner notices. In a high-profile home, that is the difference between a system that works and a system that the homeowner trusts. Trust is the deliverable, not the gear.
What is “self-healing” and why does it matter in a luxury home?
Self-healing is the philosophy that the system should sense when gear is not communicating correctly and auto-reboot the equipment to recover. without the homeowner ever knowing. We use Domotz to oversee the system, IP power to physically reboot, and a logic layer to tie them together. The router hangs at 3am while the household is asleep. The system sees it within 60 seconds. Power-cycles the router. The router comes back up. By morning everything is fine and the homeowner never knew it failed. The phrase I use with clients is this: the house does not need to work all the time. It needs to work every time the customer touches it. That is what self-healing buys you. Without it, the homeowner finds the failure first, and that is the wrong order. that is when trust in the system breaks.
How should the home be monitored after move-in?
Proactively, not reactively. We deploy Domotz on every project so we have visibility into network health, gear status, internet connectivity, UPS state, and rack temperatures from our office. When something starts trending wrong. a switch port flapping, a UPS showing degraded battery, a thermostat losing connection. we see it before the homeowner does. Most of the time we fix it remotely or we schedule a visit for the next routine maintenance. In a true Care Plan model, the homeowner pays a flat fee for ongoing monitoring, firmware updates, system checkups, and a guaranteed response time. The opposite model. install and walk away. is how high-profile homes end up with systems the homeowner stops trusting two years after move-in. Pick an integrator who plans for the relationship after the install, not just the install.
How do you actually work with the other trades on a new build?
We treat them as teammates. Pool, irrigation, HVAC, security, electrical, low voltage, AV. every trade has something the integrator needs to know, and every trade has a chance to leave us a future highway if we just ask. The pool vendor story is the perfect example: we pulled extra Cat cable at the pool unit during the original install. Years later, the pool vendor updated the pool control. Because the wiring was already there, the upgrade happened with zero additional cable run, the homeowner got phone control direct from the unit, and the integration to the rest of the system improved overnight. None of that happens if I do not work hand-in-hand with the pool vendor at the original install. Same logic with HVAC (thermostat communication, equipment monitoring), security (shared cabling pathways, integration with the control system), irrigation (controller integration, leak protection), and electrical (panel locations, lighting infrastructure, EV, generator, surge). The integrator who shows up at the trade meetings makes everyone’s job easier and saves the homeowner real money long-term.
What is the actual cost of value-engineering the right answer out of a project?
Sometimes the savings are not worth it, and the Owner’s Rep’s job is to show the math on both sides. We had a project where the customer was looking at adding Ketra in a few areas. Just a few rooms, to keep the budget in check. We sat down and walked them through what they were really saving by not doing the whole home. the cost of going back later to add Ketra to the rest of the rooms, the design discontinuity, the maintenance complexity of running two different lighting systems in the same house, and the lost daily experience in every room they had skipped. Once they saw the actual delta. not the marketing number, the real number. they felt the savings were not worth it. They ended up putting Ketra throughout the entire home. They got exactly what they wanted. That is the lesson: a good Owner’s Rep shows you the math on both the cheap line and the right line, and lets you make an informed decision instead of an exhausted one. Sometimes the cheap line is genuinely the right call. Sometimes it is a trap. The homeowner deserves to know which one they are looking at.
What do you wish every builder did differently on a new luxury build?
Five things, every time. One: bring the integrator into design meetings before electrical rough-in, not after. Two: assume conduit, not just wire. and run more of it than feels reasonable. Three: do not let drywall close until the integrator has signed off on every rough-in. Four: leave service paths to every rack, panel, and termination point, not buried behind built-ins. Five: stop treating low voltage as the trade that finishes last on a tight schedule. pre-wire is foundational, and a builder who treats it that way ends up with happier homeowners and fewer callbacks. Builders who do those five things end up with referrals from happy homeowners. Builders who do not end up with punch lists that never close, because the homeowner is permanently disappointed in the integration of their own house.
How do I know my integrator is acting as my advocate, not selling me their margin?
Five questions you can ask any integrator before signing. One: are they at the architect and GC design meetings, or are they showing up after framing? If after framing, they are not playing Owner’s Rep. Two: do they push back on the GC and other trades when something is wrong? If they always say yes, they are not advocating for you, they are protecting the relationship with the GC. Three: do they show you both numbers. the cheap line and the right line. and explain the delta? Or do they just give you one quote? Four: do they have a current high-end project they can describe in real detail, including the trade-offs? We are doing a current ultra-high-end project in Tennessee right now where part of our role is exactly that. quality control across all the trades. Five: do they offer a real post-install monitoring and care relationship, or do they install and walk away? An integrator who is not planning to be in your life two years from now is not an advocate. They are a vendor. There is a difference.
What does Restrepo Innovations actually deliver as Owner’s Rep on a new build?
We engineer and design the systems. We sit at the design table with the architect, the builder, and the other trades. We mark up the plans before rough-in. We spec the conduit, the cable runs, the rack location, the panel locations, the keypad layouts, and the rough-in locations for every TV, speaker, camera, and shade. We coordinate with the electrician, the HVAC tech, the pool vendor, the irrigation contractor, the security trade, and the low-voltage installers. We run quality control through framing, rough-in, drywall, finish, and commissioning. After move-in, we monitor the system 24/7 with Domotz, we maintain it under a Care Plan, and we make sure it works every time the customer touches it. As an Elite Pro Crestron Dealer, HTA Luxury Certified, OSHA Certified, and Ubiquiti UISP / Pro Partner team, we serve NJ, NY, and CT. and we travel for the right projects, like our current ultra-high-end engagement in Tennessee. If you are designing a new build and want a straight answer about what an Owner’s Rep relationship actually looks like, my number is 201.405.2022 and I will tell you the truth even when it is uncomfortable.
