The distinction that matters most before the walls close: Soundproofing keeps sound from passing through walls, floors, and ceilings. Acoustic treatment controls how sound behaves inside the room. They are different problems, solved by different construction, measured by different standards. A theater that does both right sounds like a theater. A theater that does only one will fail at the other end.

Soundproofing vs. Acoustic Treatment. The Distinction That Costs the Most Money on a Build

Most of the expensive mistakes on home theater builds come from conflating these two things. They are not interchangeable, and treating one as a substitute for the other is how a client ends up with a room that fails in the most disappointing way possible. after the walls are closed.

Soundproofing. Energy Transmission

Soundproofing controls how much acoustic energy passes from one space into another. It is a structural problem. The relevant measurements are STC (Sound Transmission Class) for airborne sound and IIC (Impact Insulation Class) for impact sound traveling through floors and ceilings. Soundproofing lives on the structural and architectural drawings. It is solved by mass (more and denser material), decoupling (breaking the rigid connection between surfaces), damping (converting vibration to heat), and meticulous air-sealing (because sound follows every air path). None of this can be meaningfully corrected after the walls are closed.

Acoustic Treatment. Behavior Inside the Room

Acoustic treatment controls how sound behaves once it is inside the space. The key measurement is RT60. the time it takes for sound to decay 60 dB after the source stops. Treatment lives on the AV and finish drawings. It is solved by absorption (panels, carpet, upholstery), diffusion (scattering panels), and bass trapping (low-frequency modal control in corners and at boundaries). Treatment can be specified and adjusted after the room is built. Construction cannot.

The Conflation That Costs Real Money

A client pays for Green Glue and resilient channel on the theater wall. The walls close. The room sounds like a racquetball court because there is no acoustic treatment inside. Or the client covers every surface in thick fabric absorption panels, and the bass still leaks into the bedroom above because the floor/ceiling assembly is a single layer of drywall on standard joists. Both scenarios represent a full rebuild cost to correct. The distinction is not academic. it is the difference between a finished room that works and one that does not.

The Construction That Actually Works

Soundproofing is not a product. It is an assembly. a combination of materials and methods that together achieve a target STC or IIC. Here is what the assemblies actually look like on a home theater build.

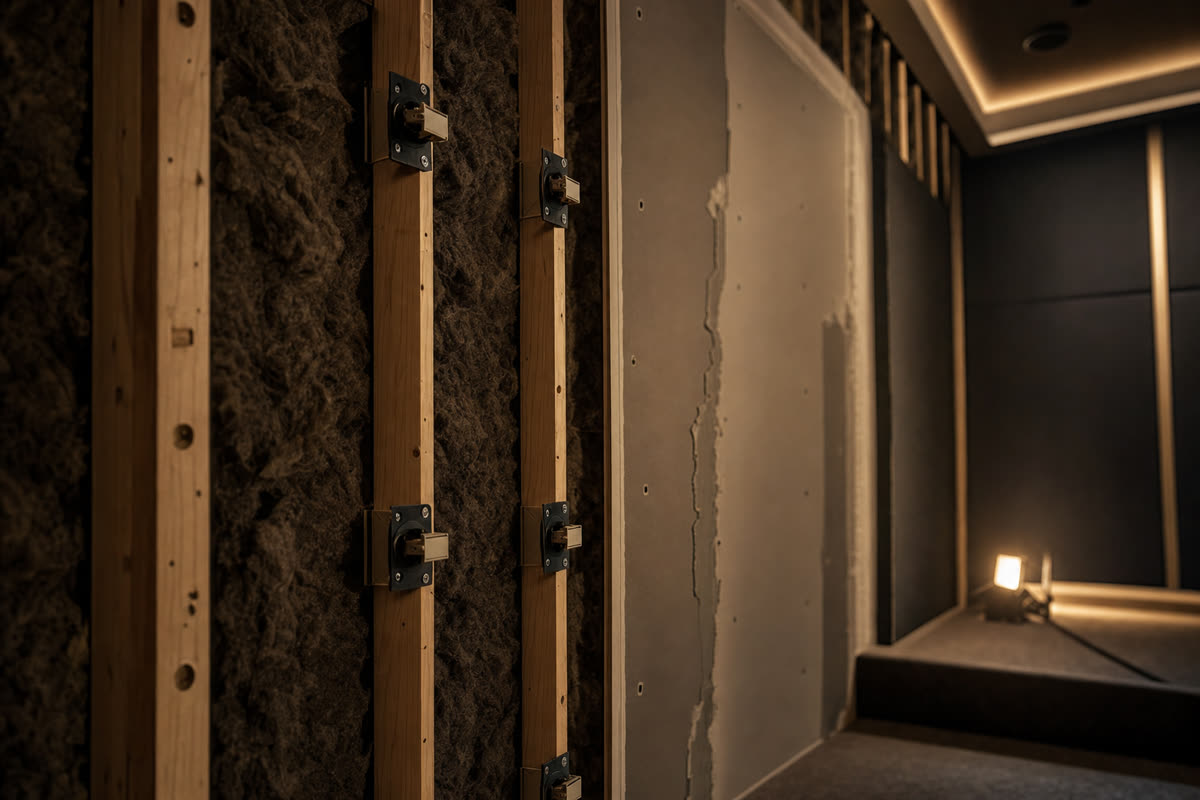

Double-Stud Wall. STC 60–65 Typical

Two separate stud walls with an air gap between them, so the two surfaces share no rigid structural connection. Mass is added on both sides with multiple drywall layers. This is the highest-performing wall assembly in residential construction. It requires the most floor plan space. typically 6 to 8 inches of wall thickness. and it must be planned at the design stage, not added later.

Staggered-Stud Wall. STC 50–55 Typical

Studs alternating between two top and bottom plates on a wider track. The drywall on each side touches only alternating studs, reducing (but not eliminating) rigid connection between the two surfaces. A practical middle ground when floor plan space is limited. Performance is meaningfully lower than double-stud, and the construction must be done correctly. a single screw through both layers into the same stud shorts the decoupling entirely.

Resilient Channel and Sound-Isolation Clips. Adds 5–10 STC Points

RC-1 resilient channel or sound-isolation clips (RSIC-1, PAC Genie Clips) attached to the framing, with drywall screwed only to the channel or clip. never into the stud. The channel or clip absorbs vibration before it reaches the drywall. This is the standard decoupling upgrade on an existing single-stud wall. Installation quality is critical: a screw that bridges the channel to the stud. called a "short circuit". eliminates the decoupling benefit entirely. The product is inexpensive; the discipline of installation is not.

Double-Layer 5/8" Type X Drywall with Green Glue

Two layers of 5/8" Type X gypsum board with Green Glue damping compound between them, applied at one tube per 16 square feet of drywall. The Green Glue converts vibrational energy into heat through viscoelastic damping. The improvement over two dry layers is real and measurable, particularly in the mid-frequency range. It does not eliminate the need for decoupling on high-performance assemblies, and it does not address low-frequency bass below roughly 100 Hz as effectively as mass and decoupling do together.

Solid-Core Doors with Full Perimeter Gasketing and a Drop Seal

A hollow-core door tests at roughly STC 12. A solid-core door with properly installed perimeter gasketing and a drop seal from Zero International or National Guard Products can reach STC 40 or better. The door is consistently the weakest point in an otherwise well-built theater wall. Every linear inch of gap at the perimeter or under the door is an acoustic bypass. Gasketing and the drop seal are not optional accessories on a high-STC assembly; they are part of the STC rating.

HVAC. The Path Most Often Ignored

Mass on the wall does not stop sound that travels through the duct. Properly specified HVAC for a theater room includes: lined ductwork and a lined plenum box to absorb airborne sound in the duct; flex duct elbows to break the direct air-path between the theater and adjacent rooms; and cross-talk silencers on shared return grilles. A shared return duct between the theater and an adjacent bedroom is a full acoustic bypass regardless of what is built into the wall separating those two rooms.

Floating Floors

On the highest-end builds. reference rooms and rooms over occupied spaces. the theater floor is built on a floating sub-floor supported by neoprene or rubber isolation pads rather than directly on the structural slab or subfloor. Mason Industries SuperW pads are a common specification. The floating assembly decouples impact energy (footfall, subwoofer vibration traveling through the floor) from the structure below. This is the only reliable way to achieve meaningful IIC performance.

Sealed Penetrations

Every electrical box, every recessed light, and every conduit penetration is an acoustic hole in the assembly. Putty pads applied to the back of electrical boxes seal the box cavity. Airtight back-boxes behind in-wall audio and video devices eliminate the cavity path. Recessed lights cut through a theater ceiling into the floor cavity above should be avoided entirely. there is no retrofit fix for that condition. Sealed penetrations are part of the rough-in coordination that Restrepo performs during construction, not an afterthought.

STC Targets by Room Type

STC targets are not arbitrary. They are a function of what is on the other side of the assembly and what the theater is expected to do at reference level. These are the practical targets for a professionally specified build.

Condition Target
Bedroom adjacent to theater STC 55–60 minimum
Theater wall shared with another conditioned space STC 60+
Theater above living space (floor/ceiling assembly) STC 60+ / IIC 55+
Reference home cinema (room within room) STC 70+ achievable

These targets assume reference playback levels. A room used primarily at lower volumes can tolerate a lower STC target on walls shared with unoccupied spaces. A room with a subwoofer array running at reference cinema levels cannot.

Where Soundproofing Fails on Luxury Builds

These are the five failure modes that come up on real projects. Most are not discovered until the room is closed and the system is calibrated at volume. By then, correcting them is a significant construction project.

1. Single Layer of Drywall on the Theater Wall

The most common failure. The general contractor builds what is on the architectural drawings. If the AV specifications were never transferred to the structural drawings, the GC builds a standard partition wall. A single layer of 1/2" drywall on standard 3-1/2" studs tests around STC 33. At reference playback, that wall is transparent. The fix requires removing and rebuilding the assembly.

2. HVAC Return Shared with a Bedroom

The duct is the bypass. Sound traveling through a shared return grille does not care what is built into the wall between the two rooms. This is a mechanical engineering oversight, not an AV oversight. but it is caught during AV design coordination if someone is looking for it. The fix requires HVAC rework: separate the return paths or install cross-talk silencers on the shared return.

3. Hollow-Core Door

A hollow-core door tests at approximately STC 12. Every other dollar spent on the wall assembly is effectively wasted if the door is hollow-core. The theater wall may test at STC 55. sound will travel through the door path as if the wall did not exist. Solid-core with a proper acoustic door kit is a day of work and a few hundred dollars in hardware. It is not optional on any serious build.

4. Unsealed Electrical Boxes

Each unsealed electrical box in a theater wall represents approximately 6 dB of STC loss at that location. Back-to-back boxes on the same wall stud are worse. Putty pads take two minutes per box during rough-in. They are not installed by default. they have to be specified, purchased, and verified. This is part of the rough-in coordination scope that Restrepo covers.

5. Recessed Lights Through the Theater Ceiling

Recessed fixtures cut through the theater ceiling into the floor cavity above are an acoustic path that cannot be sealed after the fact. The light housing penetrates the assembly, and the heat requirements make sealing the housing impractical. The specification answer is: surface-mount or semi-recessed fixtures in the theater, or airtight IC-rated fixtures with an acoustic back-box above them. This decision is made on the lighting design drawings, not after the ceiling is closed.

Ready to get the soundproofing spec right before the walls close?

What We Do, and Where We Hand Off

Restrepo specifications the soundproofing assemblies and coordinates the construction. We do not install drywall, hang doors, or pour floors. That is the general contractor’s scope, and that is the honest framing.

In practice, this is what the coordination looks like: we work from the architect’s drawings and red-line the assemblies during low-voltage rough-in. We specify the wall types, isolation clip product, drywall schedule, door hardware, HVAC modifications, and penetration sealing requirements. The GC builds to that spec. On reference-level builds, an acoustic consultant verifies the construction independently.

Restrepo handles design coordination, rack-room isolation, conduit and back-box specification, and post-build calibration of the audio system against the room that was built. We do not claim to be acoustic consultants. On projects with AV scope above $200k. or any room-within-room construction. we recommend engaging an independent acoustic consultant. Firms we work alongside include PMI Engineering (Anthony Grimani) and Acoustic Sciences Corporation. These are firms and professionals whose work we respect; they are not Restrepo affiliates, and Restrepo holds no certification through them.

Where It Ties In

Soundproofing is one layer of a larger system. The pages and posts below cover the work that connects to it:

  • Home Theater. acoustic treatment for the inside of the room, speaker placement, calibration. The other half of what soundproofing is not.
  • Media Room. lower STC targets apply, but the assemblies still matter. A media room that bleeds into the next room is not a media room.
  • Surround Sound. bass is the hardest frequency range to contain. The subwoofer output is only as good as the assembly holding it in the room.
  • Networks and Low Voltage. data cabling, AC conduit, and every low-voltage penetration through a soundproofed wall requires the same sealing discipline as any other penetration. This is coordinated at rough-in.
  • Home Theater Acoustic Treatment. the companion post on what happens inside the room once the construction is right.
  • Acoustic Treatment. The Invisible Upgrade. why acoustic treatment is often the last line item and the one that most changes the result.
  • Soundproofing vs. Acoustic Treatment. the full written breakdown of this distinction, with construction photos and measurement examples.

Frequently Asked Questions

What is the difference between soundproofing and acoustic treatment?

Soundproofing controls how much sound passes through a wall, floor, or ceiling. It is a structural problem, measured by STC (airborne) and IIC (impact), and solved during framing. Acoustic treatment controls how sound behaves inside the room once it is there. It is a finish problem, measured by RT60 and modal analysis, and solved with absorption, diffusion, and bass trapping. A room can fail at one without failing at the other. Most do-it-yourself builds fail at both.

What STC rating do I need for a home theater?

The answer depends on what is on the other side of the wall. A theater wall shared with a bedroom needs STC 55 at minimum; STC 60 is the practical target for reference-level playback without disturbing sleep. A theater above a living space needs STC 60 on the floor/ceiling assembly and IIC 55 or better for impact. A purpose-built reference room with room-within-room construction can reach STC 70 or higher. The STC target drives the assembly, and the assembly drives the budget. Start there.

Can you soundproof a theater after the walls are closed?

Partially, and at significant cost and disruption. The most effective soundproofing measures. decoupled framing, double-stud walls, floating floors. require the room to be open. Once the walls are closed, options are limited to adding mass with another drywall layer and Green Glue, sealing penetrations, upgrading the door assembly, and addressing the HVAC path. These can move the needle, but they cannot substitute for proper construction. The right time to address soundproofing is before framing. The second-best time is now, with honest expectations.

Does Green Glue actually work?

Yes, within its scope. Green Glue is a viscoelastic damping compound applied between two layers of drywall. It converts vibrational energy into heat. One tube per 16 square feet is the correct application rate. Applied correctly, it adds meaningful STC improvement over two dry layers alone. It does not replace decoupled framing, and it does not address low-frequency bass below roughly 100 Hz as effectively as mass and decoupling do together. It is one tool in the assembly, not a substitute for structural work.

Why does my theater bleed into the bedroom above it?

Almost always one of four causes: no decoupling between the theater ceiling and the floor above (structure-borne vibration travels through the framing regardless of surface materials), a shared HVAC return duct that bypasses the wall assembly entirely, recessed lights cut through the theater ceiling into the floor cavity above, or a single drywall layer where two were specified. Each path is a different fix. Identifying which one requires a walk of the construction, not a guess.

Do I need an acoustic consultant for a home theater?

For a media room or a standard dedicated theater, a well-specified AV integrator working from the architectural drawings can coordinate the soundproofing assemblies without an independent consultant. For reference rooms. projects with AV scope above $200k, room-within-room construction, or specific acoustic performance targets. an independent acoustic consultant adds value that we cannot replicate. We regularly recommend firms like PMI Engineering (Anthony Grimani) and Acoustic Sciences Corporation on those builds. They verify the construction independently. That is worth the fee.

Do you install the soundproofing yourselves?

No. The soundproofing construction. framing, drywall, door hanging, floor assembly. is the general contractor’s scope. We spec the assemblies, red-line the architectural drawings during rough-in, and coordinate conduit and back-box placement so every penetration is sealed to spec. We also handle rack-room isolation and post-build calibration of the audio system. The honest framing is this: we make sure the GC builds it right. We do not build it ourselves.
